What OEM Buyers Should Check Before Purchasing Small Motors

By BODENMOTION Engineering Team

Many OEM motor projects fail even when the selected motor meets datasheet specifications. This happens because critical application information is missing during supplier evaluation, leading to integration failures.

To avoid project delays, OEM buyers must provide suppliers with complete application requirements—including load, duty cycle, and thermal constraints—not just target specifications for the DC motor being evaluated.

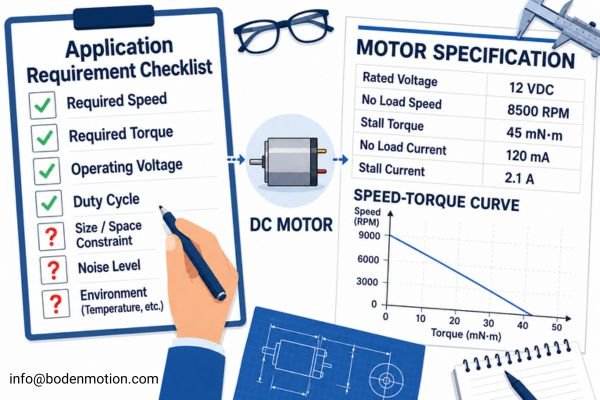

OEM engineer reviewing small DC motor specifications and application requirement checklist

So why does this disconnect between datasheet performance and real-world results happen so often? From my experience, the numbers on a spec sheet are just a starting point. The real challenge is understanding how that motor will behave once it’s inside your system, interacting with your mechanics, electronics, and thermal environment. This is where system-level thinking is critical, and where many purchasing decisions unfortunately fall short.

Why Do Many OEM Motor Projects Fail Before Mass Production?

Your prototype works perfectly, but after the first production run, units start failing in the field. The motor part number is the same, so what went wrong?

Most motor selection failures happen because datasheet values are measured under ideal lab conditions, which rarely match the thermal and load stresses inside a compact, fully integrated OEM device.

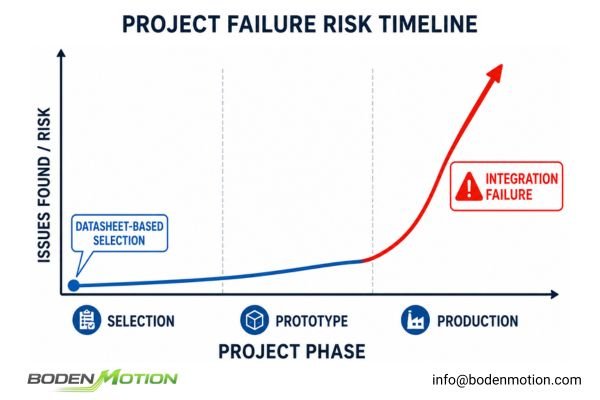

Project timeline graph showing OEM motor selection phase vs integration failure phase

In over 15 years of helping OEMs integrate motors, I've seen a consistent pattern. A motor's performance is typically rated on an open-air test bench with a stable power supply and plenty of room for cooling. Your application is likely the exact opposite: a sealed enclosure, limited airflow, and long cable runs causing voltage drops that can reach 0.5–1.5V in compact systems.

Real Integration Challenge: A datasheet will never account for the thermal resistance of your product's plastic enclosure, the voltage drop across a 2-meter cable, or the acoustic noise created when the motor's vibration resonates with your mounting bracket.

For instance, an engineering team developing a portable diagnostic tool might specify a motor based on its continuous torque rating. But they may not have fully defined the startup load, which can be 2–5 times higher for a few hundred milliseconds when overcoming initial friction or fluid viscosity. In mass production, those brief moments of high stress, combined with an enclosure temperature that might be 10–15°C hotter than the lab, lead to premature failure. The issue wasn't the motor's quality; it was an incomplete requirement definition from the start.

What Application Requirements Should Be Defined Before Contacting Suppliers?

Contacting a motor supplier without a clear set of application requirements is a recipe for delays. You'll get generic recommendations that rarely fit your specific system needs.

Before you even start a conversation, you should have a clear document defining your required torque, speed range, voltage, duty cycle, ambient temperature, and available installation space.

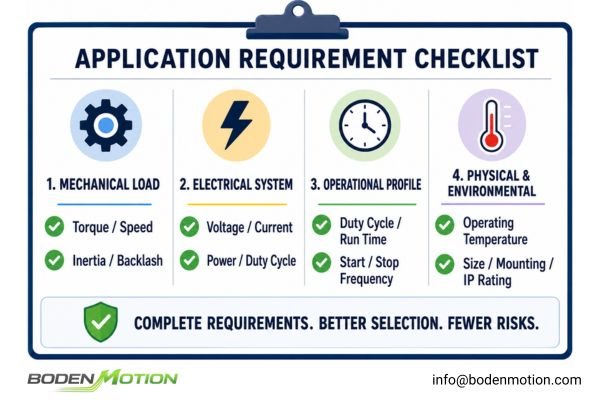

OEM application requirement checklist for small motor selection

I've seen many purchasing managers send emails asking for "a 12V, 5000 RPM motor." Honestly, that tells a motor engineer almost nothing. What work does it need to do? Under what conditions? Without this context, any recommendation is just a guess. The quality of a supplier's recommendation depends directly on the quality of the application information you provide.1

Use this checklist to prepare your Request for Quotation (RFQ) for much faster and more accurate supplier feedback.

RFQ Checklist for Small Motor Sourcing

Category Parameter Required Information
Mechanical Load Torque Peak (startup) and continuous (running) torque in mNm.2
Speed Operating RPM, required accuracy, and speed range.
Load Type Inertial, frictional, constant, or variable load profile.
Electrical System Voltage Nominal operating voltage (V) and acceptable range (e.g., 24V ±10%).
Current Limit Maximum allowable current draw (A) from the power supply or driver.
Driver Type PWM frequency (kHz), control method (e.g., trapezoidal, FOC).
Operational Profile Duty Cycle On-time vs. off-time (e.g., 2s on / 8s off), cycles per minute.
Lifetime Required operating hours or cycles (e.g., 5,000 hours, 1M cycles).
Physical & Thermal Dimensions Max diameter and length (mm), shaft requirements.
Environment Operating temperature range (°C), humidity, ingress protection (IP).
Thermal Path Enclosure material, airflow, proximity to other heat sources.

Presenting this information upfront transforms the conversation from "Do you have this part?" to "How can we solve this motion problem together?"

How Should OEM Buyers Evaluate Torque, Speed, and Duty Cycle Requirements?

Simply stating a "10 mNm torque requirement" on a purchase order is dangerously ambiguous. Is that for startup, continuous running, or a brief peak load?

You must distinguish between continuous torque (what the motor can handle without overheating) and peak torque (short-term demands like startup), and analyze your duty cycle to prevent thermal failure.

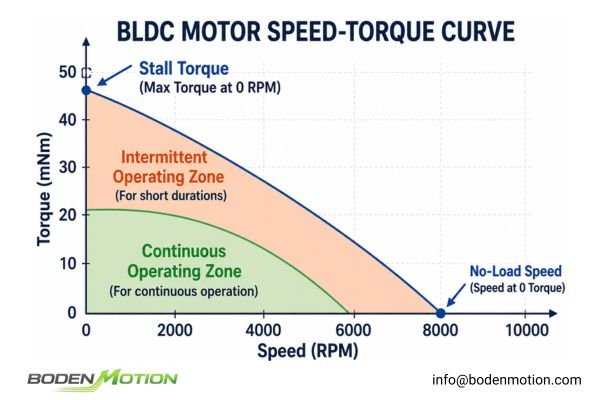

Speed-torque operating curve for a brushless DC motor showing continuous and intermittent zones

The speed-torque curve is a motor's performance map. It shows you how much torque the motor can produce at a given speed. There are two critical zones: the continuous operating zone and the intermittent (peak) zone. Running in the intermittent zone for too long will cause the motor to overheat and fail.3 The relationship P = Tω (Power = Torque × Angular Velocity) governs this trade-off; for a given power input, increasing torque means decreasing speed, and vice-versa.

Common OEM Mistake: Underestimating startup or "stiction" torque. In a laboratory analyzer, the torque needed to actuate a syringe pump and overcome the initial seal friction can be significantly higher than the running torque. If you only select a motor for its running torque, it will struggle or stall at every startup, drawing high current and eventually burning out.

Duty cycle is another frequently misunderstood parameter. A 10% duty cycle (e.g., 1 second on, 9 seconds off) allows the motor to handle much higher peak loads than continuous operation. However, you must ensure the "off" time is long enough for the motor to dissipate the heat. In compact, battery-powered equipment with no airflow, cooling is slow.4 I've seen systems where a 50% duty cycle (e.g., 30s on, 30s off) led to failure because residual heat accumulated over each cycle, pushing the motor into thermal runaway.

Why Should Thermal Management Be Considered Before Motor Selection?

Your chosen motor meets every single performance spec on your test bench. But once you install it in the final product casing, it overheats and fails within minutes.

Thermal management must be evaluated before motor selection because a motor's true continuous performance is dictated by its ability to dissipate heat within the final product's enclosure.

Illustration of thermal path and heat buildup inside a compact medical device with a motor

In the world of compact OEM devices, heat is the number one enemy of reliability. A motor's continuous torque rating isn't a measure of its strength; it's a thermal limit.5 It represents the maximum torque the motor can produce indefinitely without its internal windings exceeding their safe temperature.

This rating is almost always determined in open air. The problem is, your handheld medical scanner or portable analysis instrument is not an open-air environment. It's a sealed plastic box with other heat-producing components.

System-Level Observation: A motor rated for 5W of continuous output on a datasheet might only deliver 2–3W continuously once inside a sealed enclosure. The higher internal temperature increases winding resistance, which can reduce motor efficiency by 5–15% and further accelerate heating—a vicious cycle.6

What Thermal Information Should OEM Buyers Provide?

When you discuss a project with a motor engineer, providing thermal data is just as important as providing load data. This information allows us to estimate the thermal derating required.

Key thermal information includes:

  • Ambient Operating Temperature: The temperature inside the product enclosure, not the room temperature.
  • Operating Duration: How long will the motor run continuously during a worst-case scenario?
  • Enclosure Details: Material (plastic, aluminum), size, and whether it's sealed.
  • Cooling Method: Is there any forced airflow (fan) or passive cooling (heat sink)?
  • Maximum Temperature Rise: Are there nearby temperature-sensitive components that limit how hot the motor can get?

Honestly, this is where many compact systems start failing. Teams spend months optimizing mechanical performance, only to realize at the end that they have a thermal problem they can't solve without a major redesign.

How Can OEM Buyers Evaluate Supplier Engineering Capability?

Choosing the cheapest motor from a catalog seems like a smart financial move. But that "savings" evaporates quickly when you spend months troubleshooting integration issues with no support.

Evaluate potential suppliers on their engineering support for application analysis, driver matching, and reliability testing—not just on the motor's price tag.

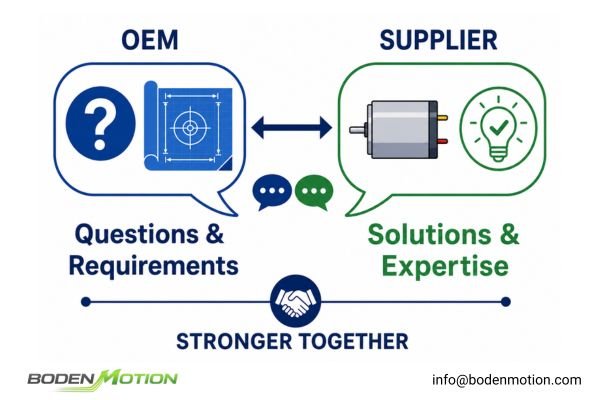

OEM engineer and supplier technical review meeting discussing motor integration

A good supplier sells you a motor. A great engineering partner helps you solve your motion control problem. Their value is demonstrated through engineering validation capabilities. This includes reviewing your application data to recommend an optimized solution, performing thermal analysis to predict temperature rise, conducting life testing under your specific load conditions, and assisting with driver matching to ensure system stability and efficiency.

In complex OEM devices, the motor is part of a system. Its performance is affected by the driver, the power supply, and the mechanical load. A supplier who understands this system-level interaction is invaluable.

What Questions Should Buyers Ask Motor Suppliers?

During the evaluation process, go beyond the price quote. Ask questions that reveal their engineering depth and commitment to partnership.

  • Application Analysis: "Here is our load profile and duty cycle. Can you help us validate this motor selection and predict its temperature rise in our enclosure?"
  • System Integration: "Our driver uses a 50kHz PWM frequency. Do you have data on how this motor behaves at this frequency? Are there any known resonance issues?"
  • Reliability & Lifetime: "How do you validate the B10 lifetime of your gearmotors? Can you provide test data under a load condition similar to ours?"
  • Customization: "We need a custom shaft length and a specific connector. What is your process and lead time for these modifications?"
  • Troubleshooting Support: "What is your process for root cause analysis if we experience a failure in the field?"

The answers will tell you whether you're dealing with a simple component vendor or a true integration partner. Strong engineering support is a critical feature that prevents costly project delays and ensures long-term product reliability.

What Common Purchasing Mistakes Lead to Motor Selection Failure?

You've gone through three different motor suppliers and your project is still behind schedule. The problem might not be the quality of the motors you're testing.

Most OEM motor selection failures originate from incomplete application requirements and communication breakdowns during the purchasing process, rather than from poor motor quality itself.

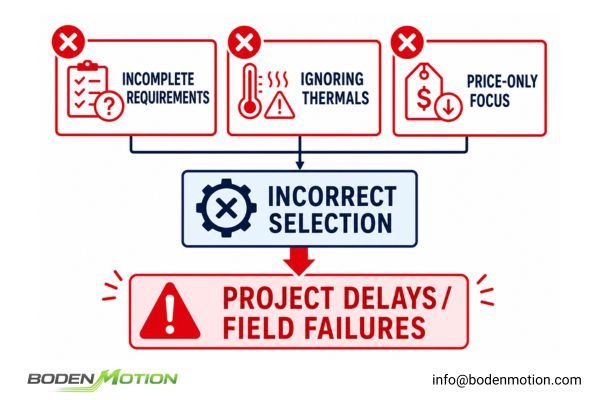

Flowchart showing common motor selection mistakes leading to project failure

From my vantage point as an engineer who is often brought in to fix these issues, the patterns are clear. Here are the most common traps I see OEM buyers and engineers fall into:

  1. Providing Incomplete Application Requirements: This is the most frequent mistake. Simply specifying voltage and RPM ignores the most important factors: torque, duty cycle, and the actual load profile. It's the equivalent of buying a vehicle without knowing if you need to haul feathers or bricks.
  2. Underestimating Thermal Constraints: A motor's datasheet performance is based on open-air testing. Burying it deep inside a sealed plastic housing with no airflow can cut its real-world continuous torque capability by 50% or more.7
  3. Ignoring Motor-Driver System Compatibility: The motor and driver are a matched pair. The wrong PWM frequency from a driver can cause a perfectly good brushless motor to become noisy, vibrate excessively, and run hot. System-level compatibility must be verified.
  4. Prioritizing Unit Price Over Total Cost of Ownership: A $3 motor that causes a 1% field failure rate on a $1,000 device is not a cost saving; it's a massive liability.8 Reliability has a price, and it's almost always cheaper to pay for it upfront.
  5. Failing to Scrutinize Supplier Reliability Data: Asking "Is your motor reliable?" will always get a "Yes." A much better question is: "Can you share the B10 life test report for this motor under a 20 mNm continuous load in a 45°C ambient environment?" The difference separates a sales conversation from an engineering one.

Conclusion

Successful motor selection isn't about finding a part that matches a spec sheet. It's about a process of system-level engineering where complete requirements—load, thermal, and duty cycle—are clearly defined. Most field failures originate from incomplete system analysis, not poor motor quality.

If you are developing a compact OEM device and want to ensure your motion system is reliable, efficient, and optimized for your real-world operating conditions, the BODENMOTION engineering team is here to help. We support application analysis, system integration, and customized solutions for medical, robotics, and automation equipment. Contact us to discuss your project.

info@bodenmotion.com

FAQ: What OEM Buyers Should Check Before Purchasing Small Motors

What is the most important parameter when selecting a small motor?

There is rarely a single most important parameter. Torque, speed, voltage, duty cycle, and thermal conditions must all be evaluated together as an integrated system.

Why is duty cycle important during motor selection?

Duty cycle directly affects heat generation, lifespan, and long-term reliability. A motor's peak performance can only be sustained for short periods before heat builds up, which is especially critical in compact systems with limited cooling.

Should buyers select motors based only on RPM and voltage?

No. RPM and voltage alone reveal nothing about a motor's ability to handle the application's load, its thermal performance, or its overall compatibility with the control system.

Should OEM buyers request motor samples before final selection?

Yes, this is a recommended practice. Samples are not for simple bench testing. The goal is to install the motor in your actual prototype and validate its performance under real-world load, duty cycle, and thermal conditions to expose any potential integration issues before committing to mass production.

Why do some motors pass prototype testing but fail in production?

This often happens when prototype testing doesn't fully replicate the worst-case conditions of mass production—higher ambient temperatures inside the final enclosure, longer operating durations, or unit-to-unit variations in mechanical friction.

What information should be provided to motor suppliers?

Provide a complete picture: required torque (peak and continuous), speed range, operating voltage, duty cycle, load profile, ambient temperature, and all physical installation constraints. A detailed RFQ checklist is the best tool.

Can BODENMOTION help evaluate motor applications before purchasing?

Yes. BODENMOTION's engineering team specializes in OEM application analysis. We support motor selection, thermal evaluation, driver matching, and provide customized engineering for compact motion systems.
